Use Cases

← Insights Energy Markets & Credit Risk

The New Cost of Entering ERCOT's Queue

A $50 Million Decision Before Construction Begins

For a 500 MW data center, Texas’s proposed large-load interconnection framework, §25.194(f)(7), currently under review at the PUCT in Project 58481, could require between $25 to $50 million of financial commitments before construction begins, plus the actual cost of the facilities needed to connect the project to the grid.

The headline number is significant. But the bigger story is how long the capital may remain committed and what happens if the project changes course.

How the Framework Works

The first commitment comes when the developer signs an Intermediate Agreement and posts refundable security equal to $50,000 per MW. ERCOT and the transmission service provider then study the project and determine what upgrades are required.

If the project withdraws before signing the Interconnection Agreement, the utility deducts its study costs and returns the remaining security.

After the study, the developer reaches the critical decision point: sign the Interconnection Agreement and may need to pay a separate, non-refundable $50,000 per MW fee, while also committing to the project’s direct interconnection costs. [While the proposed rule stacks these two fees, PUCT Staff’s April 2026 non-binding comments on Batch Zero proposed netting any unused Stage 1 security against the Stage 2 fee and dropping that fee as a Batch Zero exit requirement. That’s a signal that the double stack language may not hold when the Commission adopts language for the final rule.]

Withdrawal becomes much more expensive after that point. Once outstanding costs are deducted, 80% of the remaining Stage 1 security is forfeited for the benefit of ratepayers, while 20% is returned to the project.

Projects that move forward do not immediately recover the Stage 1 security. It remains outstanding through construction and energization, with the balance released over five years of sustained operation. Depending on the project timeline, the security could remain in place for roughly seven to nine years.

Batch Zero Is Moving Ahead Before the Rule Is Final

Project 58481 remains pending, but ERCOT’s Batch Zero process is already operating under approved protocols. That creates a transition risk: if the final rule changes the amount, eligible instruments, or release mechanics, existing agreements and collateral may need to be adjusted.

Developers entering the process now should build that flexibility in from the start.

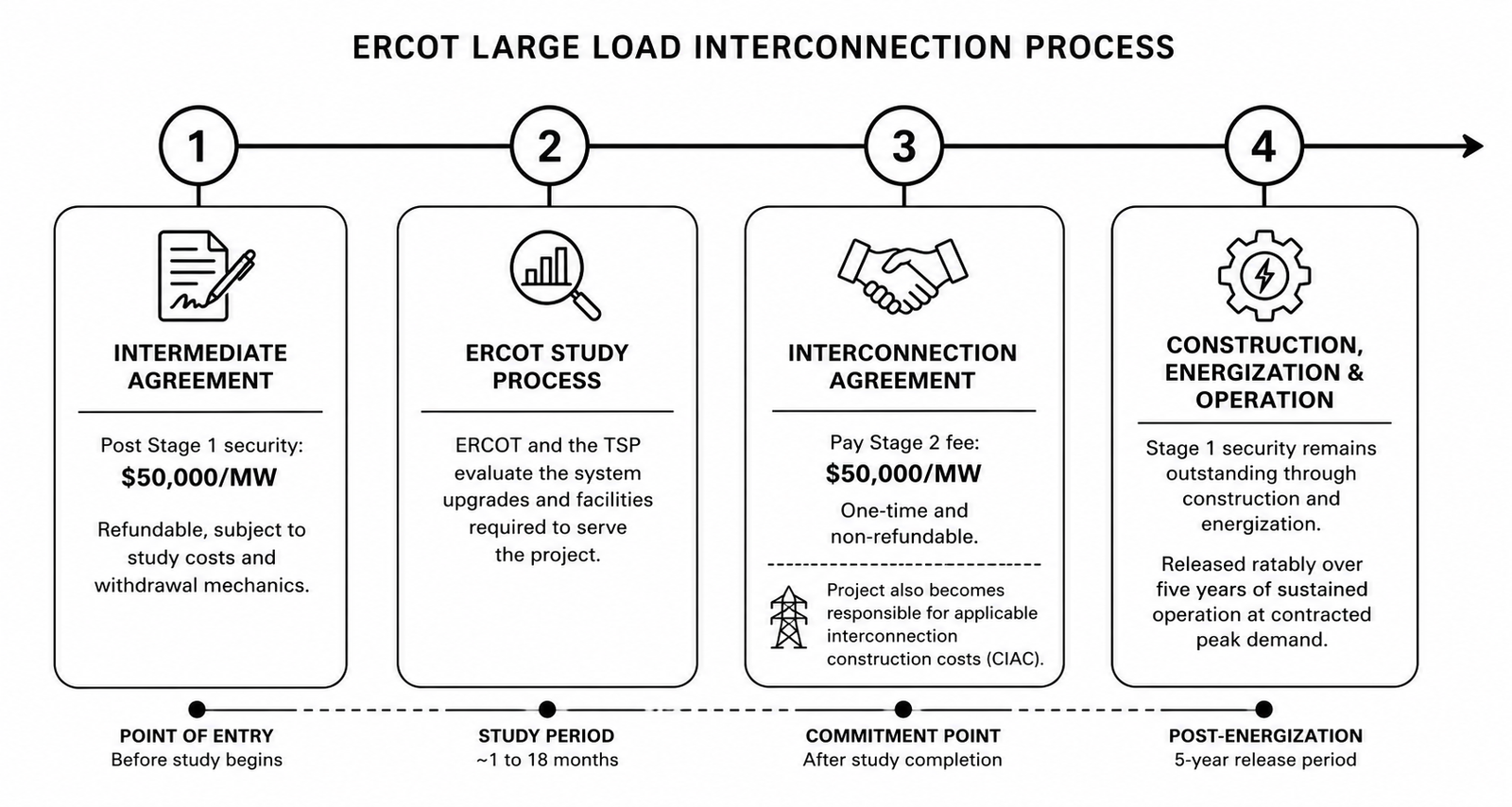

ERCOT interconnection queue financial framework

What This Means for the Market

The Queue Should Become More Credible

Requiring meaningful capital early in the process should make it harder to hold speculative queue positions. Projects with stronger sites, financing, customers, and execution plans will be better positioned to advance, giving ERCOT a clearer picture of demand that is more likely to materialize.

Collateral Becomes A Larger Part of the Capital Strategy

A long-dated cash posting can compete directly with land, equipment, and construction spending. Letters of credit, guaranties, and potentially other approved instruments may preserve liquidity, but their cost, capacity, renewal risk, and tenor will matter almost as much as their initial availability.

The Study Period Becomes the Key Decision Window

Before the Interconnection Agreement, a developer still has meaningful flexibility. After it, the project has paid the non-refundable fee and faces the 80/20 forfeiture structure.

That makes the study period a crucial time to validate financing, customer commitments, construction costs, and the project’s ability to reach contracted demand. In a more capital-intensive ERCOT queue, developers with flexible, durable collateral and the disciplined decision making will have a meaningful advantage.

Got a deal that hinges on power or counterparty risk?

That's our entire job. Comity de-risks energy transactions — lowering counterparty risk, improving project returns, and freeing up capital. Emailing us or booking a 30-minute call is the fastest way to find out how we can help.

Email Us Book a 30-Minute Call
